Amplify DesignI&R Design Consultant · APEGA

CSA C282 Annual Testing Guide for Alberta Buildings

September 30, 2026 Ibrar Ahmad, P.Eng. · APEGA 1518 words · 7 min read
CSA C282 Annual Testing Guide for Alberta Buildings
Timeline showing the stepped loading procedure for an emergency generator load test
Step-load schedule showing duration and applied percentage of rated generator capacity during mandatory annual testing.

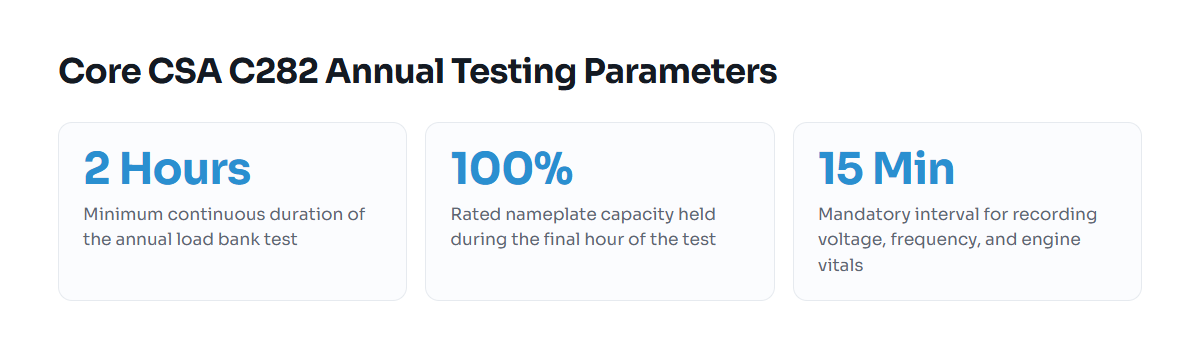

Key numbers governing CSA C282 annual emergency generator testing
Primary operational durations, loading thresholds, and logging intervals required during annual generator verification.

CSA C282 annual testing requires a full load-bank test of the emergency generator for at least two consecutive hours, laboratory sampling of diesel fuel, and operational verification of all transfer switches and auxiliary subsystems. In Alberta, building owners must perform these inspections annually under the National Building Code (Alberta Edition) and local fire prevention bylaws to ensure life-safety power remains operational during a utility outage.

The Purpose and Schedule of CSA C282 Annual Verification

CSA C282 defines the design, installation, maintenance, and testing requirements for emergency electrical power supply systems in buildings. Where an emergency generator feeds life-safety loads such as exit signs, fire pumps, emergency lighting, and smoke control systems, the standard enforces a scheduled maintenance regime. Building codes across Canada, including the National Building Code (Alberta Edition) 2023, mandate compliance with CSA C282 for emergency equipment.

Emergency generators frequently sit idle or run only during short, unloaded monthly exercise cycles. These light-load conditions allow unburned fuel and carbon deposits to accumulate in the exhaust system, a condition known as wet stacking. Light running also fails to confirm that the cooling system can dissipate heat under maximum design demand or that the voltage regulator stabilizes under full load. The annual inspection serves as a proof test. It confirms that the engine, alternator, mechanical ventilation louvres, day tank pumps, and control systems operate properly under real emergency conditions. To understand the design baseline that feeds into this testing, review our guide to Emergency Generator Requirements for Buildings.

Governing Codes and Mandatory Annual Test Tasks

In Alberta, the requirement to install and maintain an emergency power supply stems from NBC(AE) 2023, which directs practitioners to CSA C282. Electrical installations follow CEC 2024 Section 46, which outlines wiring methods and transfer arrangements for emergency systems. Routine operation, inspection, and maintenance must strictly follow the tables in CSA C282.

The annual testing regime contains several mandatory technical milestones that exceed regular weekly or monthly visual checks:

Load Testing Parameters: 200 kW Diesel Generator Example

To understand the electrical and mechanical load conditions encountered during annual compliance, consider a typical commercial building with a 200 kW, 250 kVA, 600/347 V, 3-phase diesel generator.

1. Full-Load Current Calculation

To select cables and load-bank steps, calculate the rated output current across the three phases:

Rated Line Current = Nameplate kVA / (1.732 × Line Voltage) = 250,000 VA / (1.732 × 600 V) = 240.6 A per phase.

The portable load bank must pull 241 A continuously at 600 V to test the engine and alternator at 100% rated capacity.

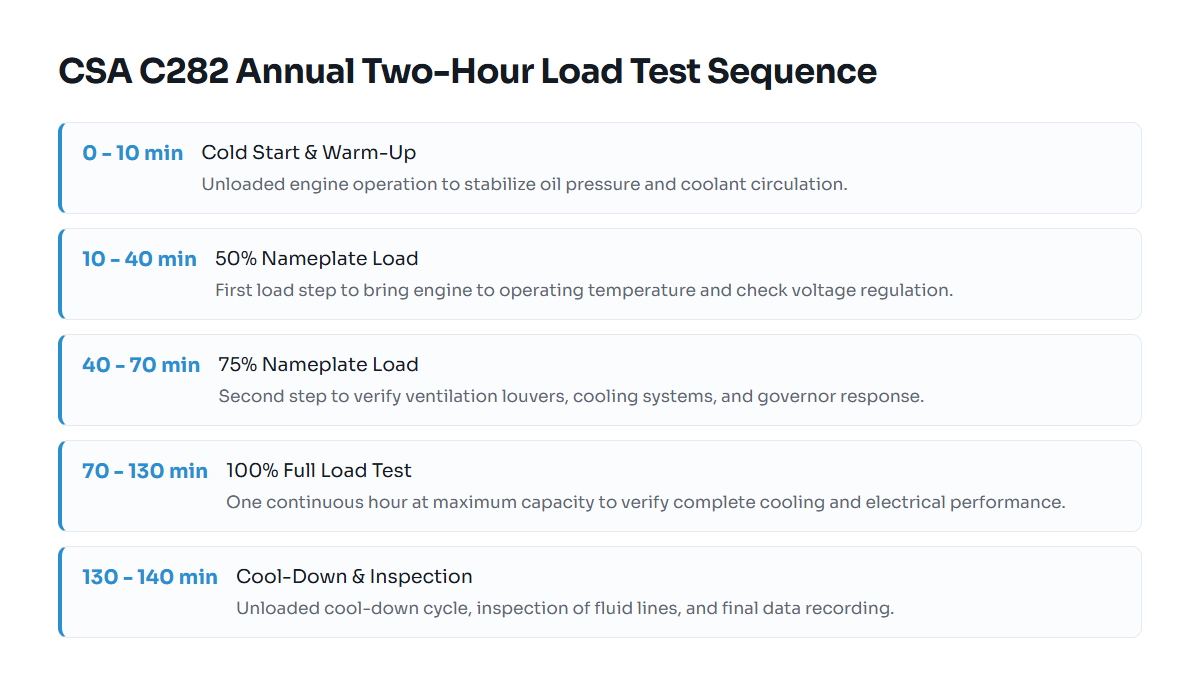

2. Step-Load Schedule

Technicians install the load bank outside the electrical room or park it on a mobile trailer, routing temporary cables to the emergency bus via dedicated cam-lock connectors or a load-bank breaker. The two-hour test follows this stepped sequence:

Test SegmentDurationApplied LoadAmps per Phase (600 V)Primary Verification Targets
Warm-Up10 minutes0 kW (Unloaded)0 AOil pressure buildup, coolant circulation, no fuel leaks.
Step 130 minutes50% (100 kW)120.3 AThermostat opening, exhaust temperature rise, voltage stability.
Step 230 minutes75% (150 kW)180.4 AMotorized intake/exhaust dampers fully open, fan operation.
Step 3 (Peak)60 minutes100% (200 kW)240.6 AMaximum cooling capacity, oil temperature plateau, frequency drop under 2%.
Cool-Down10 minutes0 kW (Unloaded)0 ATurbocharger cool-down, shutdown timer function.

3. Fuel Consumption During Test

A modern 200 kW tier-compliant diesel generator consumes roughly 55 to 60 litres of fuel per hour at full load. During a complete test setup—including pre-checks, stepped loading, full capacity running, and cool-down—the unit will consume approximately 100 to 120 litres of diesel. Facility managers must confirm the main storage tank has sufficient reserve to complete the test while retaining the code-required run time (typically 2 hours for life safety, up to 72 hours for high-hazard or health care occupancies) for actual emergencies.

Common Points of Failure in Alberta Installations

Annual inspections frequently uncover preventable equipment and procedural faults. Addressing these items before the annual test contractor arrives avoids re-testing expenses and municipal inspection notices:

Annual Inspection and Verification Checklist

The facility maintenance team or testing contractor should record the following checkpoints in the permanent on-site log book mandated by CSA C282:

For facility managers preparing for building alterations, service upgrades, or emergency power retrofits, engaging qualified electrical engineering services in Alberta ensures your standby systems comply with all municipal safety bylaws and technical standards.

Free tools: kVA to amps calculator

Common questions

Can we use regular building loads instead of a portable load bank for the CSA C282 annual test?

You may use building electrical loads only if they can maintain continuous rated capacity (up to 100% of generator nameplate) for the required duration. Because building loads fluctuate and rarely reach full generator capacity, a portable resistive load bank is almost always required to achieve the code-prescribed loading steps.

Who is qualified to perform CSA C282 annual generator testing in Alberta?

Testing must be conducted by qualified personnel, typically certified generator service technicians or master electricians who specialize in emergency power equipment. The testing contractor must possess calibrated instrumentation, load-bank equipment, and a certified laboratory connection for diesel fuel sampling.

How does CSA C282 annual testing relate to annual fire alarm testing?

During annual fire alarm testing under CAN/ULC standards, technicians must verify all input signals between the generator system and the fire alarm panel. This includes signals for generator running, common trouble alarms, and transfer switch positions to ensure life-safety operators receive immediate notice of emergency power status.

What happens if our diesel fuel fails the annual laboratory analysis?

If the laboratory report shows elevated water, sediment, or microbial growth, the fuel must be polished (filtered and treated with biocides) or pumped out and replaced with fresh fuel. Continuing to operate emergency life-safety systems with out-of-spec fuel violates building maintenance regulations and risks catastrophic fuel filter plugging during an outage.

Are natural gas generators subject to the same CSA C282 annual test requirements as diesel sets?

Natural gas generators installed as life-safety power supplies under CSA C282 must undergo the same two-hour full-load test and transfer switch verifications. However, they are exempt from fuel sampling requirements, provided their fuel supply complies with local code allowances for natural gas service.
