Row Housing Electrical Service Design in Alberta

Bar chart comparing 202 kW total connected load against 78.7 kW calculated demand for a 6-unit row house
Calculations based on standard CEC 2024 Section 8 multi-unit residential diversity rules for an all-electric 6-unit townhome.

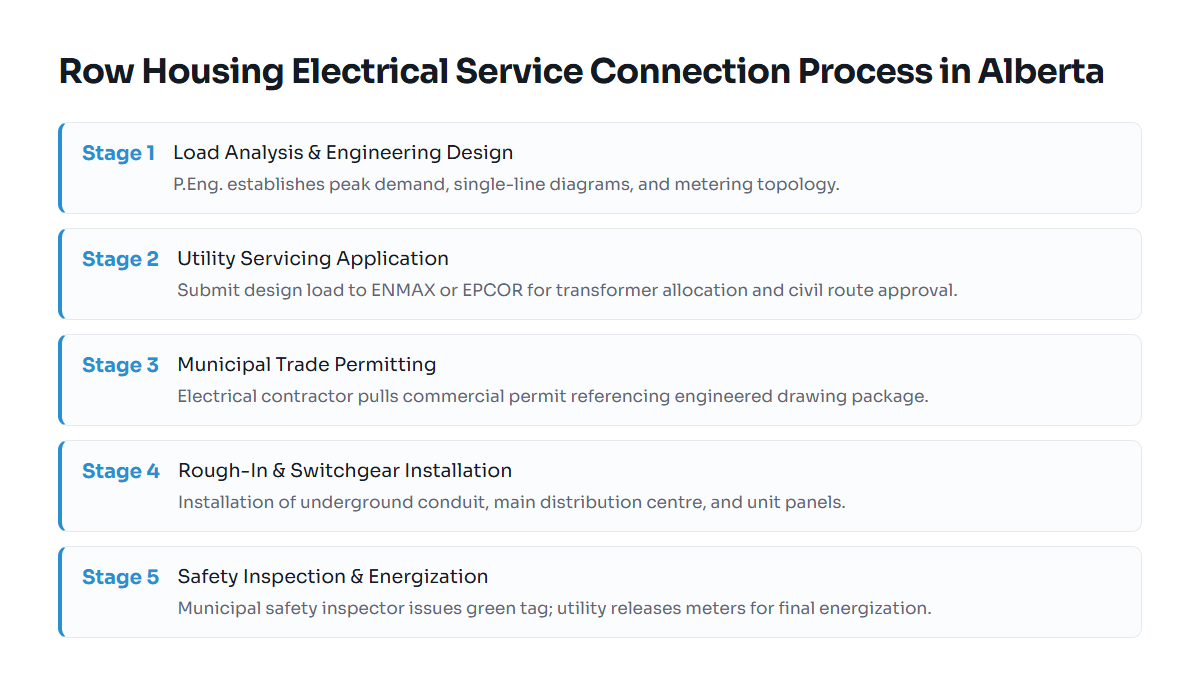

Step-by-step timeline of an Alberta multi-unit residential electrical connection from engineering design to meter energization
Standard workflow for utility and municipal coordination on row housing projects under Alberta Safety Codes.

A row housing electrical service requires either individual direct utility connections for fee-simple street-facing townhomes or a central multi-meter distribution centre for condominium developments. Sizing depends on an electrical load analysis under Canadian Electrical Code (CEC) Part I 2024 Section 8, applying demand factors to calculate peak coincident load rather than simply summing individual panel ratings. Most multi-unit row townhomes settle on a central 400 A to 800 A service at 120/208 V three-phase or 120/240 V single-phase.

Row Housing Electrical Service: Configuration and Capacity

Designing electrical infrastructure for row housing requires an early choice between individual utility services and centralized multi-meter switchgear. In a fee-simple development where individual owners hold title to the land directly beneath their townhouse, local utilities such as ENMAX in Calgary or EPCOR in Edmonton often mandate separate underground service conductors from a street transformer to each unit. Each home receives a dedicated meter base on its exterior wall or in a recessed meter alcove. This eliminates common property but multiplies civil trenching costs and site congestion.

In a condominium structure where common property exists, developers usually install a single main utility service feeding a central multi-meter distribution panel board. This switchgear contains a central service disconnect, utility metering compartments, and feeder breakers feeding sub-panels inside individual residential units. Individual suite sub-panels are typically rated at 100 A or 125 A, providing sufficient capacity for modern appliances, domestic heat pump systems, and electric vehicle branch circuits.

Understanding system sizing requires distinguishing between connected load and calculated demand. What parameter indicates the electrical demand on a system? The operating electrical demand is indicated by the peak coincident volt-amperes (VA) or calculated peak amperes, rather than the nameplate ratings of the connected equipment. The ratio of this peak coincident load to the total connected load is the demand factor in electrical design. Because residents do not run ranges, clothes dryers, space heaters, and car chargers simultaneously at maximum power, the CEC permits designers to apply demand factors to determine service entrance ampacity.

Governing Rules: CEC 2024 Section 8 and Metering Codes

Electrical load calculation for multi-unit residential buildings in Alberta is governed by Section 8 of the CEC 2024. Designers must calculate the minimum ampacity of the main service conductors and switchgear using the multi-unit dwelling calculation methods outlined in Section 8 rather than adding individual unit panel capacities together.

Under Section 8, the service calculation incorporates:

For projects requiring electrical engineering services in Alberta, utility requirements also dictate the physical design. The ENMAX Customer Metering Specification and EPCOR Customer Connection Guide set strict limits on meter heights, working clearances (minimum 1.0 m clear in front of metering equipment), and the maximum number of meters grouped in single enclosures. In institutional electrical design or commercial electrical design Alberta projects, engineers size services based on continuous operational profiles. Row housing relies heavily on residential diversity factors to keep transformer and switchgear sizes practical.

Worked Example: Sizing a 6-Unit Row House Service

Consider a typical two-storey row housing project in Calgary containing six residential units. Each townhouse unit has a conditioned floor area of 110 m², an all-electric appliance profile, and a dedicated parking space equipped with EV charging provisions. For a comparable calculation on smaller buildings, refer to our article on Electrical Design for a 4-Plex: Service Sizing and Loads.

Each unit contains the following connected electrical load:

Without diversity, the connected load is approximately 38 kW per suite, which would suggest a 160 A requirement per unit at 240 V. Applying the individual unit demand calculations in Section 8 yields a calculated unit demand of approximately 19 kW (79 A at 120/240 V single-phase). Each unit receives a 100 A, 120/240 V single-phase suite panel.

For the central building service feeding all six units, CEC Section 8 allows the designer to apply tiered multi-unit demand factors to the combined loads. The base loads and cooking loads are aggregated, with diversity percentages applied as the unit count increases. Heating, water heating, and unmanaged EV loads are combined using governing continuous factor rules. For this six-unit block, the aggregate demand calculation produces a total building design demand of approximately 78 kW.

Using our kVA to Amps Calculator, this 78 kW (78 kVA at unity residential power factor) translates to:

MetricPer Unit (Calculated)6-Unit Total (Unmanaged)6-Unit Total (With CEC Diversity)
Base Living Area Load6.0 kW36.0 kW18.5 kW
Cooking Equipment6.0 kW72.0 kW (connected)17.0 kW
HVAC & Water Heating8.0 kW48.0 kW36.0 kW
EV Charging (Managed)1.2 kW (effective)46.0 kW (connected)7.2 kW
Total Calculated Demand21.2 kW (88 A @ 240 V)202.0 kW (841 A @ 240 V)78.7 kW (328 A @ 240 V)
Recommended Service100 A Suite Sub-panelNot Applicable400 A Main Service Switchboard

Where It Goes Wrong in Practice

Service sizing errors in row housing projects typically emerge at the intersection of utility standards, building classification, and municipal permits. Common points of failure include:

Pre-Construction Electrical Checklist for Row Housing

  1. Confirm Tenure Structure: Establish whether the project is fee-simple or condominium. This dictates individual street metering versus central distribution.
  2. Execute the Electrical Load Calculation: Retain an electrical engineer Calgary developer rely on to perform formal load analyses under CEC 2024 Section 8.
  3. Submit the Utility Servicing Application: Engage the utility early with calculated peak demand figures to verify transformer capacity and establish point-of-service locations.
  4. Coordinate Spatial Allocations: Provide dedicated clearance for meter centers, panels, and transformers (minimum 3.0 m from combustible building openings).
  5. Obtain Permit Support for Electrical Design: Ensure electrical drawings carry the required professional engineering stamp for commercial and multi-family municipal permit submission.

Engineering fees for row housing design depend on building density, electrical service size, site layout, utility complexity, and municipal approval requirements. To discuss your project or request a fee proposal, contact our Calgary team at 825-438-1945 or consult our online engineering notes and insights.

Free tools: kVA to amps calculator

Common questions

What parameter indicates the electrical demand on a system?

The electrical demand on a system is indicated by the peak coincident load measured in volt-amperes (VA), kilovolt-amperes (kVA), or amperes over a specific operating interval. It reflects actual active power draw rather than the total theoretical connected load of all installed equipment.

Can I pull a Calgary homeowner electrical permit for a row housing unit?

No. The City of Calgary explicitly limits homeowner electrical permits to single-family homes occupied by the legal owner. Multi-family buildings, including row housing and condominium developments, require a certified electrical contractor under a commercial electrical permit.

What is the typical electrical service size for a row house unit?

Individual townhome units generally receive a 100 A or 125 A, 120/240 V single-phase panel. When multiple units share a central service entrance, the main distribution panel typically ranges from 400 A to 800 A depending on heating profiles and EV charging infrastructure.

How does demand factor in electrical design affect service entrance switchgear?

Demand factor represents the ratio of maximum coincident demand to total connected load. By accounting for the reality that all appliances do not operate simultaneously, applying demand factors prevents oversized transformers, cables, and switchgear, keeping utility and installation costs practical.

What factors influence municipal electrical permit cost in Alberta?

Municipal electrical permit costs in Alberta are determined by the local authority having jurisdiction based on total project valuation, square footage, or total service ampacity. Every permit also includes a mandatory province-wide Safety Codes Council levy.
