Amplify DesignI&R Design Consultant · APEGA

FortisAlberta Service Application Process Explained

October 3, 2026 Ibrar Ahmad, P.Eng. · APEGA 1434 words · 6 min read
FortisAlberta Service Application Process Explained

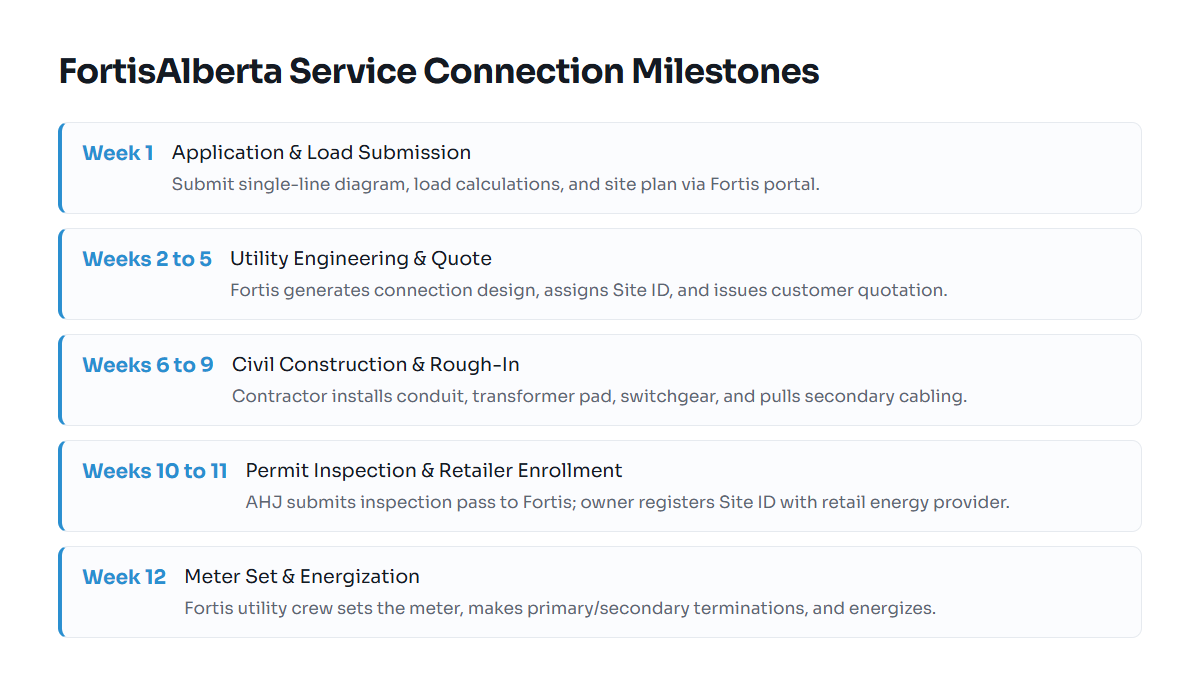

Timeline showing stages of FortisAlberta application from filing to energization
Typical timeline for commercial service connections based on standard FortisAlberta lead times and Alberta municipal inspection practices.

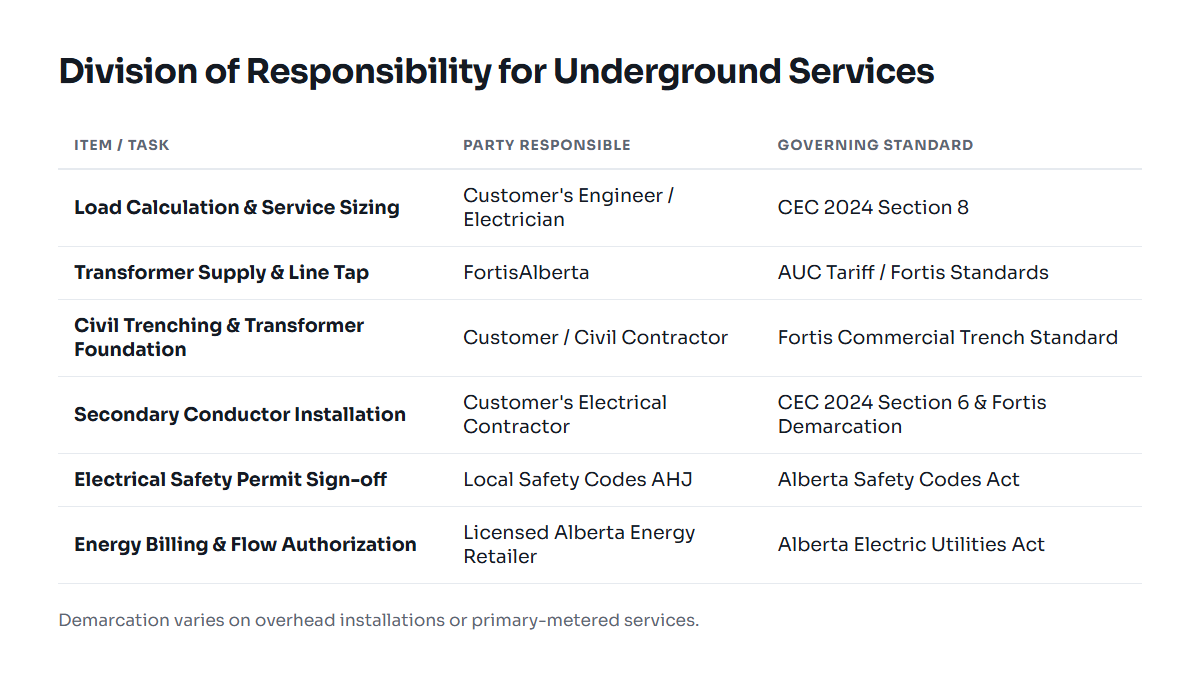

Responsibility breakdown between FortisAlberta, Customer, and Retailer
Demarcation of civil and electrical obligations derived from FortisAlberta Customer Connection Guides.

To connect a new or upgraded electrical service in FortisAlberta service territory, you must submit a service connection request with a calculated load, execute a customer quotation, install the required civil infrastructure, obtain an electrical permit inspection pass from the local safety codes authority, and enroll your designated Site ID with a competitive retail electricity provider. FortisAlberta will not schedule meter installation or service energization until the safety codes inspection sign-off and retailer enrollment both clear in their system.

Understanding the Alberta Utility and Safety Codes Framework

Electrical connections in Alberta operate under a deregulated electricity market and a strict division of responsibility between the distribution wire service provider, the competitive retailer, and the Safety Codes Authority Having Jurisdiction (AHJ). FortisAlberta owns and operates the poles, wires, and utility transformers across much of rural and suburban Alberta. They do not sell the electricity that flows through those wires, and they do not inspect building electrical wiring.

Three distinct frameworks govern any FortisAlberta service application:

For systems with complex metering or higher voltage levels, review our guide on Primary vs Secondary Metering in Alberta to determine if high-voltage delivery makes economic sense for your facility.

Worked Example: New 400 A Commercial Service

Consider a new 700 m² commercial shop located in Rocky View County. The building requires a 120/208 V, 3-phase, 4-wire, 400 A electrical service fed underground from an existing FortisAlberta three-phase overhead powerline across the roadway.

Step 1: Electrical Load Calculation

The engineer calculates the consumer service demand in accordance with CEC 2024 Section 8. The continuous heating, lighting, and general motor loads produce a calculated design load of 88 kVA (244 A at 208 V). The service entrance switchboard is sized at 400 A to permit future tenant expansion.

Step 2: Service Application Submission

The applicant creates a project on the FortisAlberta portal. The application includes:

Step 3: Engineering Review and Quotation

FortisAlberta reviews utility line capacity. To supply 88 kVA, FortisAlberta assigns a standard 112.5 kVA three-phase padmount transformer. FortisAlberta provides a Customer Connection Quotation detailing:

Step 4: Civil Works and Trenching

Under FortisAlberta commercial standards, the customer provides trenching and conduit on private property. The contractor installs:

MilestoneResponsible PartyDocumentation RequiredTypical Duration
Load and site plan filingApplicant / Electrical EngineerLoad calculation sheet, single-line diagram, CAD site plan1 to 2 weeks
Utility engineering & quoteFortisAlbertaConnection proposal and construction quotation3 to 6 weeks
Civil & conduit installationGeneral / Electrical ContractorTrench log, conduit pull verification, transformer pad prep1 to 3 weeks
Permit inspection sign-offSafety Codes AHJElectrical permit number, final inspection pass1 to 3 days
Retailer enrollmentBuilding Owner13-digit Site ID, chosen energy retail contract3 to 5 days
Transformer set & meter energizationFortisAlbertaAHJ inspection notification, active retail registration5 to 10 business days

Where Service Applications Stall

Projects regularly encounter unnecessary delays during utility coordination. The four most common points of failure in FortisAlberta territory are:

1. Unenrolled Site ID

FortisAlberta is legally prohibited from turning on power until an authorized retail electricity provider requests energization. Many owners wait until the electrical contractor passes final inspection before calling an energy retailer. If the Site ID is not actively enrolled with a retailer (such as Enmax, Direct Energy, Epcor, or an independent retail provider), the Fortis field truck will decline the meter set work order, delaying occupancy by several days.

2. Short-Circuit Current Incompatibility

When FortisAlberta specifies a transformer close to your service equipment, the available utility fault current can exceed standard commercial panel ratings. A 112.5 kVA, 120/208 V padmount transformer with low impedance can produce short-circuit currents requiring 22 kA or 42 kA interrupting ratings on your service switchboard. Failing to request the available fault current from FortisAlberta early in design results in rejected switchgear inspections. You can verify system parameters using our voltage drop and SCCR calculator.

3. Non-Compliant Civil Infrastructure

FortisAlberta maintains strict guidelines for clearances around padmount transformers: typically 3.0 m clear working space in front of the cabinet doors and 1.0 m on the sides and rear from combustible walls or vegetation. Installing window openings, downspouts, gas meters, or decorative retaining walls within these clear zones will cause Fortis utility inspectors to fail the civil works, halting transformer installation.

4. Discrepancies Between Permit Address and Utility Site ID

Municipal street numbering sometimes updates between preliminary subdivision design and final occupancy. If the building address on the municipal electrical permit differs by even a unit number from the address linked to the FortisAlberta Site ID, the electronic permit transfer system between the Alberta Safety Codes authority and FortisAlberta will not match. Work orders freeze automatically until records are manually rectified.

For complex installations involving commercial buildings, engaging qualified electrical engineering services in Alberta early avoids equipment rework, incorrect switchgear orders, and utility re-engineering fees. Review our ongoing collection of engineering notes and insights for practical design workflows across Western Canada.

Checklist for FortisAlberta Service Energization

Follow this sequence to ensure your installation proceeds from design to energization without site delays:

  1. Determine Service Sizing: Complete CEC Section 8 load calculations to identify required service voltage, continuous running load, and total service size.
  2. Initiate Service Application: Log into FortisAlberta's online portal at least 12 to 16 weeks prior to the required in-service date. Upload the electrical single-line diagram and site plan showing proposed transformer and meter locations.
  3. Obtain Utility Design and Quotation: Review the Fortis utility design package. Verify utility fault current levels and confirm transformer foundation specifications. Execute the quotation agreement and pay required contributions.
  4. Obtain Municipal Electrical Permit: The electrical contractor must pull the electrical permit using the exact municipal address and legal land description registered on the Fortis work order.
  5. Construct Civil Infrastructure: Install transformer concrete pad (or vault), secondary trench, conduit runs with utility-grade pull strings, and ground rods matching FortisAlberta commercial customer installation guides.
  6. Select Retail Energy Provider: Provide the 13-digit Site ID to your chosen electricity retailer at least 10 business days before requested energization. Confirm the retailer has submitted a connection transaction to the wire service provider.
  7. Call for AHJ Electrical Inspection: After the main service switchboard, metering base, ground electrode, and customer conductors are terminated, request the rough-in and service electrical inspection from your local safety codes inspection agency.
  8. Confirm Electronic AHJ Release: Ensure the safety codes inspector transmits the electrical inspection pass to FortisAlberta.
  9. Final FortisAlberta Energization: Fortis crews verify trench/pad installation, terminate secondary cables at the transformer, install the revenue meter, and energize the service.

Free tools: kVA to amps calculator

Common questions

What is a FortisAlberta Site ID?

A Site ID is a unique 13-digit number assigned by FortisAlberta to a specific physical service location in Alberta. You need this number to set up an account with a competitive retail electricity provider, who then authorizes FortisAlberta to energize the meter.

Who installs the transformer for a commercial service in FortisAlberta territory?

FortisAlberta supplies and installs the utility transformer. However, the customer is generally responsible for supplying and installing the civil infrastructure on private property, including the transformer concrete pad, trenching, conduit, and secondary conductors to the transformer lugs.

Why did FortisAlberta refuse to install my meter after the electrical inspector passed my building?

The most frequent cause is missing retailer enrollment. Passing the municipal safety codes inspection releases the electrical hold, but FortisAlberta cannot supply energy until a competitive retail electricity provider confirms a contract for that Site ID.

How far in advance should I apply for a commercial electrical service with FortisAlberta?

You should submit your service connection application 12 to 16 weeks before your target energization date. Projects requiring utility line extensions, highway crossings, or custom transformer sizing require additional engineering and procurement lead time.

Can I install my main service panel before FortisAlberta approves my application?

You can install equipment at your own risk, but this often leads to costly rework. If FortisAlberta designates a higher fault current than your switchgear can handle, or requires a different metering enclosure configuration, the safety codes inspector will fail the final installation.
