Electrical Permit Alberta: Requirements & Rules

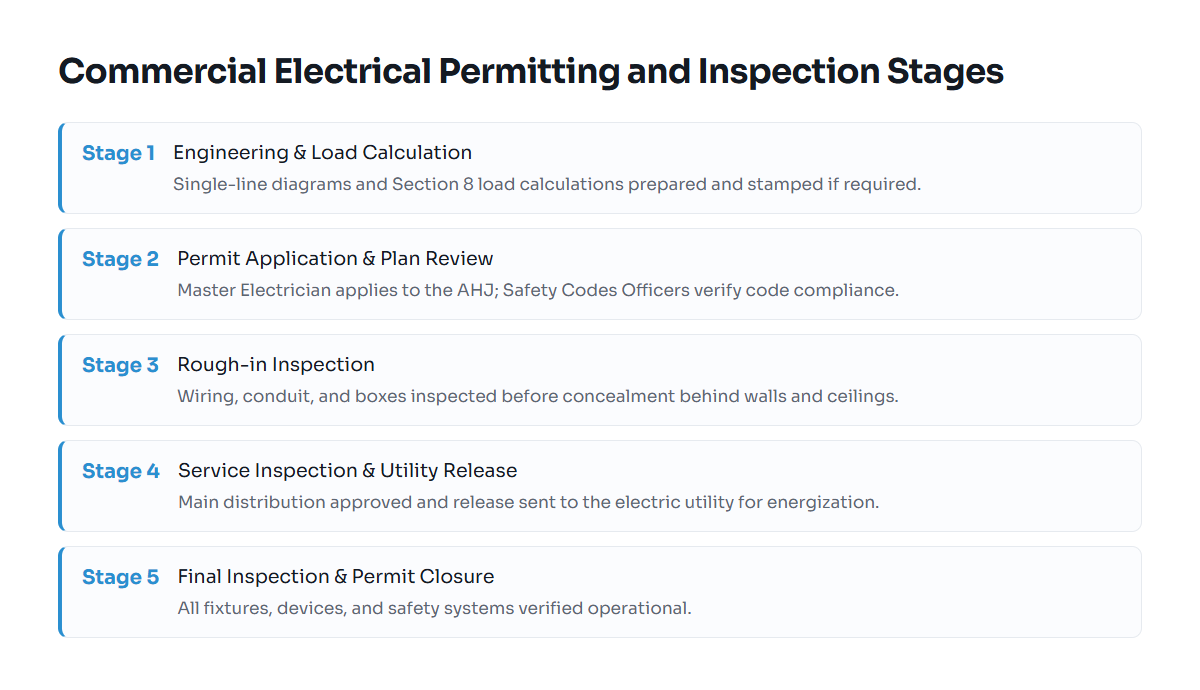

Timeline showing the sequence of electrical permitting and inspections in Alberta
Standard workflow for commercial electrical permit approval and site inspection milestones under the Alberta Safety Codes Act.

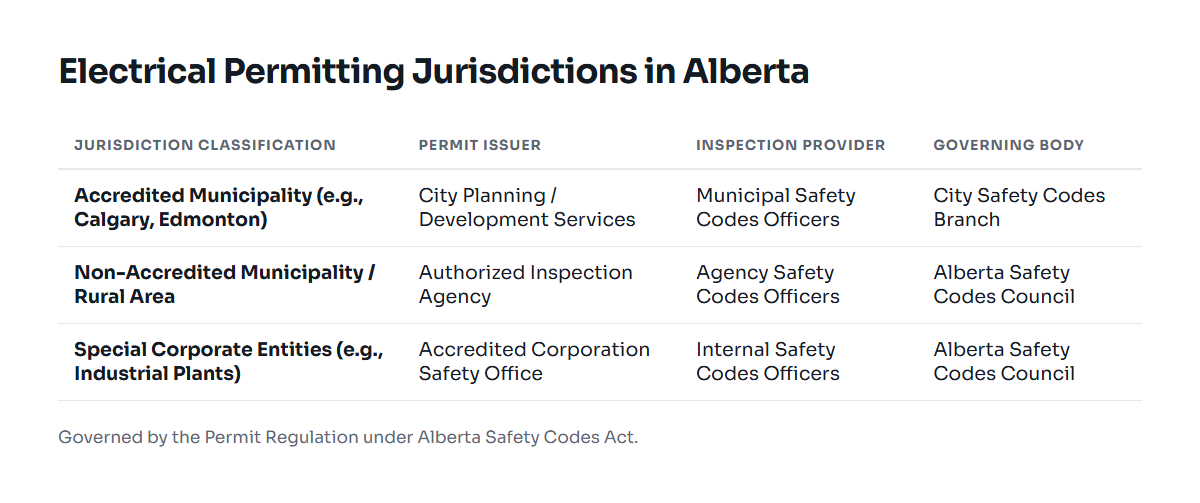

Comparison of accredited versus non-accredited permit processing in Alberta
Permit routing depends on municipal accreditation status under the Alberta Safety Codes Act.

An electrical permit in Alberta is a legal authorization issued under the Safety Codes Act that grants permission to install, alter, or extend electrical systems. The permit confirms that the planned work complies with the Canadian Electrical Code (CSA C22.1) and provincial regulations. In most commercial, institutional, and multi-family applications, permits must be obtained by an Alberta-certified Master Electrician representing a registered electrical contractor before work begins.

Overview of Electrical Permits in Alberta

The province of Alberta enforces technical safety through the Safety Codes Act and the Electrical Code Regulation. These statutes mandate that electrical work requires a permit unless specifically exempted by regulation. Minor maintenance tasks, such as replacing a light switch with an equivalent device or replacing a single ballast, do not require a permit. Installing new branch circuits, altering electrical services, adding transformers, or replacing distribution panels always require one.

Permits serve two legal functions. First, they notify the local Authority Having Jurisdiction (AHJ) that regulated work is taking place. Second, they initiate the formal inspection lifecycle, establishing inspection checkpoints that confirm code compliance prior to concealment and energization.

Permit administration across Alberta depends on local municipal status:

For detailed drawing requirements before submission, review our guide to Electrical Permit Drawings: Alberta Requirements and Review.

Alberta Safety Codes and Engineering Standards

Two primary code standards govern electrical installations within the province: the Canadian Electrical Code Part I (CSA C22.1-24), formally adopted as the electrical standard in Alberta, and the National Building Code (2023 Alberta Edition). The Building Code establishes the baseline requirements for fire separations, emergency power distribution, exit signs, and fire alarm integration, while the CEC dictates conductor ampacities, overcurrent protection, grounding, bonding, and wiring methods.

Section 8 of the Canadian Electrical Code sets the calculation parameters for service and feeder sizing. The code distinguishes between connected load and calculated demand load:

The Association of Professional Engineers and Geoscientists of Alberta (APEGA) establishes practice standards governing when drawings must be sealed by a Professional Engineer (P.Eng.). In commercial, industrial, and institutional occupancies, municipalities require engineered and sealed drawings when services exceed defined thresholds (often 200 A or 400 A depending on the AHJ), for systems exceeding 600 V, or for life safety installations such as fire alarm verification and emergency lighting systems. Our team provides comprehensive electrical engineering services in Alberta to support contractors and developers through this review process.

Commercial Electrical Permit Workflow and Calculation Example

To understand how an electrical permit moves from design to completion, consider a typical commercial tenant fit-out in an accredited Alberta municipality.

Step 1: Engineering Load Analysis

A contractor prepares to renovate a 300-square-metre commercial retail unit in a strip mall fed by a 120/208 V, 3-phase, 4-wire utility service. Before submitting the permit application, the engineer or contractor must determine the required feeder ampacity using the load calculation rules of CEC Section 8.

The unit inventory consists of:

Total connected load equals 36,000 W. Applying Section 8 demand factors:

Because these commercial loads operate during normal store operating hours, minimal diversity applies. The total calculated demand is 36,000 W (36 kW).

We calculate the three-phase line current using the formula:

Line Current (I) = Demand (W) / (1.732 × Line-to-Line Voltage)

I = 36,000 W / (1.732 × 208 V) = 36,000 / 360.26 = 99.93 A

A 100 A, 120/208 V, 3-phase distribution panel matches the calculated demand. If continuous loads exceed 80% of the breaker rating, standard branch protection rules require a 125 A panel with conductors sized accordingly to maintain allowable temperature limits. You can evaluate feeder sizing and voltage limits directly using our voltage drop and SCCR calculator.

Step 2: Plan Review and Permit Issuance

The contractor submits the single-line diagram, panel schedule, and floor layout to the local municipality. The safety codes officer checks the plans against CEC Section 8 calculations, fault current ratings, and disconnect locations. Once approved, the permit is issued. Permit costs are determined by the municipality or authorized agency based on project valuation or square footage; see our detailed breakdown of Electrical Permit Cost in Alberta: $150 to $5,000+.

Permit TypeApplicant EligibilityEngineering Seal Required?Typical Review Timeline
Residential HomeownerProperty owner (single-family, must reside there)No1 to 3 business days
Commercial Tenant ImprovementMaster Electrician under licensed contractorOften required (AHJ discretion / >200 A)5 to 15 business days
New Commercial / InstitutionalMaster Electrician under licensed contractorYes (APEGA standard / building classification)10 to 20 business days
Annual Maintenance PermitCertified plant electrician or designated contractorNo (for maintenance and like-for-like repairs)5 business days

Common Misconceptions

Misunderstandings regarding the Safety Codes Act frequently cause project delays, fines, or uninspected work. Four common errors stand out in commercial construction:

Related Requirements and Inspection Lifecycle

Securing the permit document is only the start of the compliance process. To achieve a final permit closure, the installation must progress through sequential field inspections:

  1. Rough-in Inspection: Performed after raceways, cables, junction boxes, and panel enclosures are installed, but before walls, ceilings, and insulation conceal the wiring. The inspector checks conductor sizing, box fill, firestop penetrations, and cable support.
  2. Service / Utility Inspection: Required when establishing a new electrical service or upgrading existing main distribution equipment. The safety codes officer checks the service head, meter base, main disconnect, and system grounding. Once passed, the AHJ issues a formal electrical release to the local distribution utility (such as ENMAX in Calgary, EPCOR in Edmonton, or FortisAlberta in rural areas) authorizing connection to the grid.
  3. Final Inspection: Conducted when all devices, fixtures, faceplates, cover plates, and utilization equipment are installed, connected, and operational. The inspector verifies panel directories, breaker ratings, ground-fault circuit interrupter operation, and emergency exit lighting illumination.

Every permit issued in Alberta also incurs the Safety Codes Council levy, a mandatory provincial fee added to all safety codes permits to fund oversight and code enforcement administration. For more engineering analysis and design practice updates, browse our technical library of engineering notes and insights.

Free tools: kVA to amps calculator

Common questions

Who is eligible to pull an electrical permit in Alberta?

Commercial electrical permits must be pulled by an Alberta Master Electrician affiliated with a licensed electrical contractor. Single-family homeowners can pull an owner's permit for their primary residence if they perform the work themselves.

What parameter indicates the electrical demand on a system?

Calculated demand indicates the system load, typically expressed in amperes or kilovolt-amperes (kVA). It accounts for connected load modified by demand factors under Canadian Electrical Code Section 8.

Do I need stamped engineering drawings for a commercial permit?

Municipalities require stamped P.Eng. drawings for complex occupancies, commercial services over defined thresholds (typically 200 A or 400 A), hazardous locations, and life safety systems.

What happens if electrical work is completed without a permit in Alberta?

Work completed without a permit violates the Safety Codes Act. The authority can issue stop-work orders, impose financial penalties, mandate destructive wall openings for inspection, or instruct the utility to disconnect power.

How does the electrical utility get authorization to energize a new service?

The local safety codes officer completes a service inspection and sends an electrical release notice directly to the distribution utility, such as EPCOR, ENMAX, or FortisAlberta.
